WRITEBACKPROJECTCOSTPROJECTION function

Created by Harry Lewis, Modified on Thu, 20 Mar at 9:03 AM by Grigorii Kosianenko

Applies to

  • Velixo NX 2025.02 or higher

  • Acumatica, MYOB Acumatica, Cegid XRP Flex, Haufe x360, and Jamis Prime

  • License: PM Module

  • Customization Package: 20250305 or higher


TABLE OF CONTENTS


Introduction

If you want to write a new cost projection for your project to your ERP, you can use the WRITEBACKPROJECTCOSTPROJECTION function. The imported cost projection will have the status On Hold and should be processed further manually in Acumatica (Remove HoldRelease)


You need to write a separate WRITEBACKPROJECTCOSTPROJECTION formula for each cost budget line in your project cost projection.


The function does not implicitly recalculate any costs or quantities for the cost projection, the same way as if you select Manual mode for the cost budget line on the Cost Projection screen in Acumatica.


The function does not accept cost projection data that cannot be released later. Even though Acumatica allows you to add lines with incomplete information, these lines cannot be released until you specify their task, account group, and other details defined by the cost projection class.


When you select the scope of the Perform Writeback action on the ribbon, all writeback functions in this scope (Current Sheet or Selected Cells) will be grouped by the project revision and written to the ERP.

Syntax

=WRITEBACKPROJECTCOSTPROJECTION(ConnectionName, Project, Revision, RevisionDate, CostProjectionDescription, CostProjectionClass, Task, AccountGroup, CostCode, InventoryId, LineDescription, ProjectedCostToComplete, ProjectedQuantityToComplete, ProjectedCostAtCompletion, ProjectedQuantityAtCompletion, ProjectedVarianceCost, ProjectedVarianceQuantity, ProjectedCompletedPercent)

Parameters

The parameters of the WRITEBACKPROJECTCOSTPROJECTION function can be divided into two groups:

  1. The settings of a revision of a cost projection for a particular project and its details

  2. The parameters of the project's cost budget line.



The parameters of the project revision should be the same for all cost budget lines you will add to the cost projection.


Parameter

Required/Optional

Description

ConnectionName

Required

The name of the connection, as specified in the Connection Manager

Project

Required

The project for which the revision is projecting costs.

Revision

Required

The revision identifier of the cost projection.

If creating a new revision, enter an identifier, which must be unique within the project. The length of the identifier, which can consist of only alphanumeric characters and spaces, can be up to 10 characters.

RevisionDate

Required

The date when the cost projection revision was created.

CostProjectionDescription

Optional

The description of the cost projection.

CostProjectionClass

Required

The cost projection class of the cost projection revision. The class is defined on the Cost Projection Classes (PM203500) form and defines the detail level of the cost projection.


The cost projection revision can include the same level of detail as the cost budget of the project for which the revision is created, or it can have less detail.


The parameters of the cost budget lines


Parameter

Required/Optional

Description

Task

Required

The project task to which the cost budget line relates.

Ensure the cost projection class has Cost Task enabled.

AccountGroup

Required

The expense account group of the cost budget line.

Ensure the cost projection class has Account Group enabled.

CostCode

Optional

The cost code that is associated with the cost budget line.

The cost code can be specified if the cost projection class has Cost Code enabled.


If you want to use Cost Codes, ensure the feature is enabled on Enable/Disable Features (SC100000).

InventoryId

Optional

The stock or non-stock item that is associated with the cost budget line.

The inventory ID can be specified if the cost projection class has Inventory ID  enabled.

LineDescription

Optional

The description entered for the cost budget line.

ProjectedCostToComplete

Required

The projected remainder of the budgeted cost for the cost budget line.

You can set the cost manually or calculate it using the following formula: Budgeted Cost - (Actual + Unbilled Committed Cost)

ProjectedQuantityToComplete

Optional

The projected remainder of the budgeted quantity for the cost budget line.

You can set the quantity manually or calculate it using the following formula: Budgeted Quantity - (Actual + Unbilled Committed Quantity)

ProjectedCostAtCompletion

Required

The projected final cost at the moment of project completion for the cost budget line.

You can set the cost manually or calculate it using the following formula: Projected Cost to Complete + Actual Cost + Revised Committed Cost – Invoiced Committed Cost

ProjectedQuantityAtCompletion

Optional

The projected final quantity at the moment of project completion for the cost budget line.

You can set the quantity manually or calculate it using the following formula: Projected Quantity to Complete + Actual Quantity + Revised Committed Quantity – Invoiced Committed Quantity

ProjectedVarianceCost

Required

The expected difference between the Projected Cost at Completion and the Budgeted Cost.

ProjectedVarianceQuantity

Optional

The expected difference between the Projected Quantity at Completion and the Budgeted Quantity.

ProjectedCompletedPercent

Required

The projected percentage of completion for the cost budget line.

You can set the percentage manually or calculate it using the following formula: (Actual + Committed Open Cost) / Projected Cost at Completion * 100%

Output

The function returns its status, which can be one of the following:

  • Pending - the formula is pending to be processed.

  • Line Uploaded - the formula was processed successfully.

  • Error - an error occurred during the processing of the formula.

Example

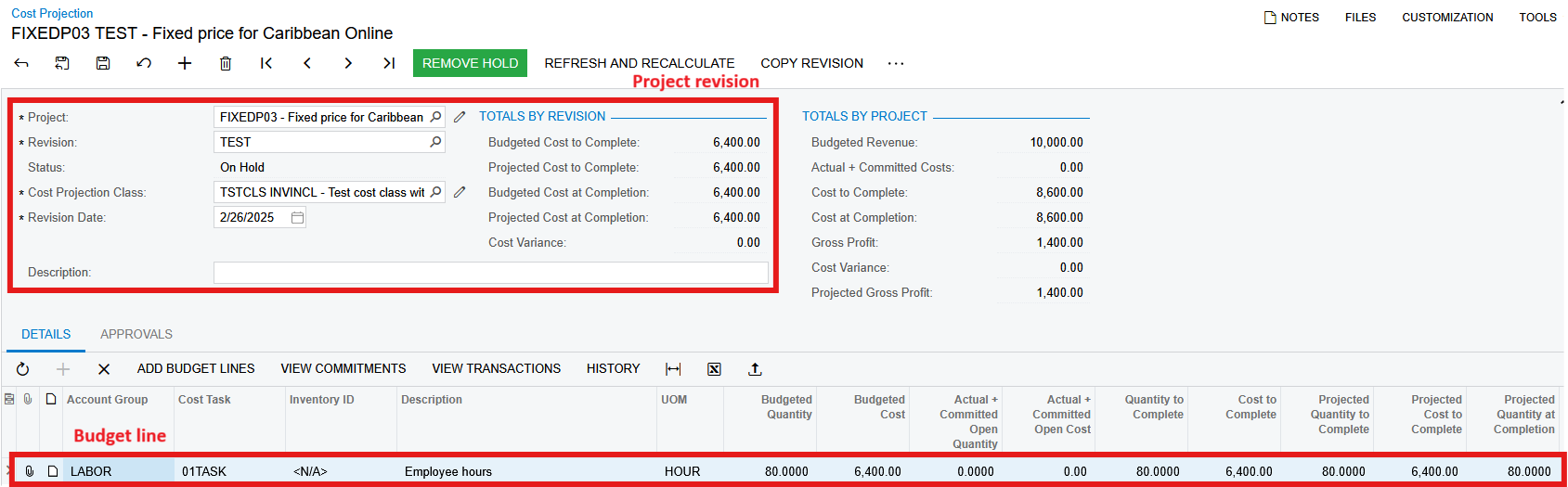

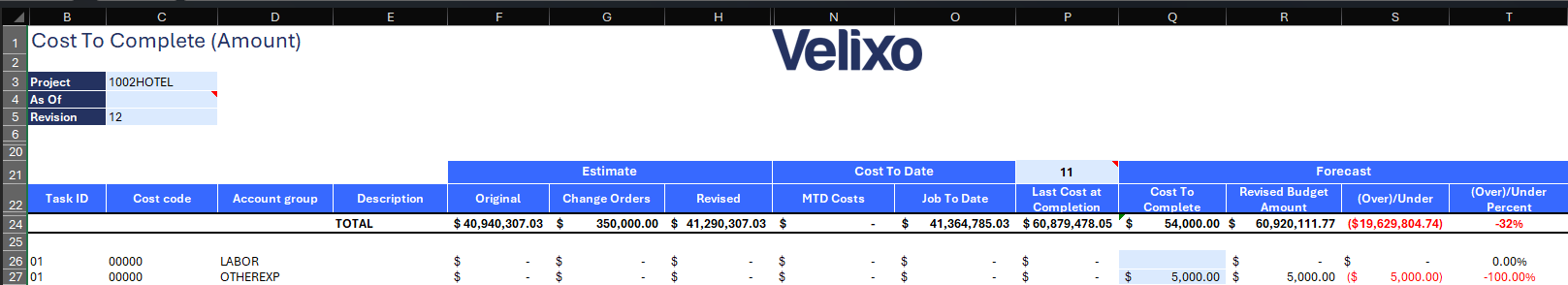

You have prepared the following workbook to write cost projections to your ERP:


You need to add a column at the end of your table and fill it with the following functions:

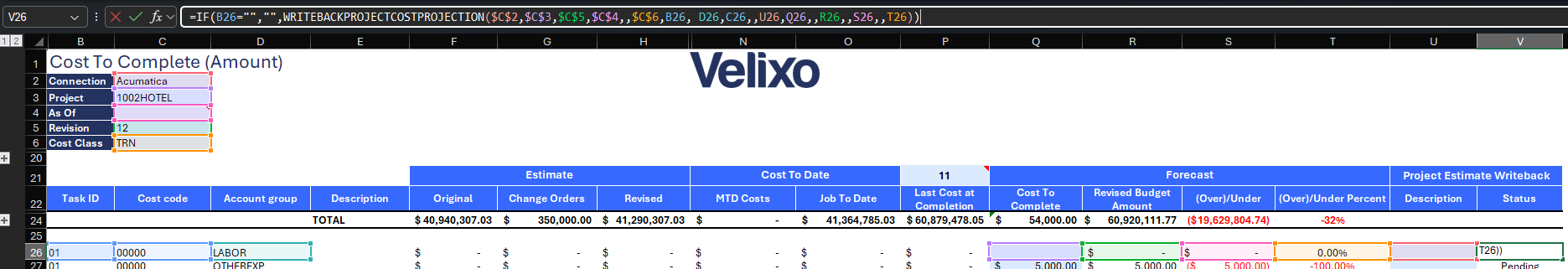

=WRITEBACKPROJECTCOSTPROJECTION($C$2,$C$3,$C$5,$C$4,,$C$6,B26,D26,C26,,U26,Q26,,R26,,S26,,T26)

You may notice that InventoryID and …Quantity… parameters are omitted. It is because the projection cost class does not include Inventory ID, which means that such a level of detail cannot be specified in this cost projection.


The result should look as the following:


Now you can fill in your data and Perform Writeback to write it to the ERP.

Was this article helpful?

That’s Great!

Thank you for your feedback

Sorry! We couldn't be helpful

Thank you for your feedback

Let us know how can we improve this article!

Select at least one of the reasons
CAPTCHA verification is required.

Feedback sent

We appreciate your effort and will try to fix the article
